The 'Welcome Centre' Project

Home | Welcome | Weekly Activities | Noticeboard | Mission Activities | Prayer | Useful Links | Contact Us | A-Z Index

Services

Boys Brigade

Girls Brigade

Noah's Ark
Baby & Toddler Group

Children's activites
Youth

Churches Together in Clacton

Increase the value of charity donations

PLEASE NOTE:
THE PICTURES ON THIS PAGE MAY TAKE A MINUTE OR TWO TO LOAD, PARTICULARLY ON DIAL-UP.

Our vision was to create a modern, welcoming, multi-purpose space for the work of God’s Kingdom through:

  • Continuing and expanding the Church’s youth and children’s ministry

  • Developing new community-centred projects to serve the needs of Clacton

  • Working together with other community groups, to enrich the lives of those around us.

Click here to see the development of the Atrium in pictures
 Dedication of the site of the new Atrium on Sunday 25th October

Atrium Site Dedication 25.10.09     Atrium Site Dedication 25.10.09

November 2009

Following a dedication of the site of the Atrium after the morning service on Sunday 25th October (below) building begins this month with completion in January 2010.  The Atrium will provide an indoor link between the Welcome Hall (completed in 2007) and the older Fellowship Hall at the rear of our Church site.  This is another exciting phase in the life of our fellowship, brought about by the generosity of a significant donation from a Church member and by grants from charitable trusts.  We thank God for his provision of enabling this generosity which has made this new phase in our Church life possible - especially so, as we could never have expected to be able to construct the Atrium so soon after the completion of the Welcome Hall (Phase 1 of the project).  Praise Him!

March 2008

Our Architect and Quantity Surveyor have begun to plan and cost the Atrium.  We are approaching charitable trusts in the hope that they will be able to support us financially in this next exciting phase.

January 2008

We are given the news that we are likely to be in a position to construct Phase 3, the atrium of The Welcome Centre, within two years.  This is incredible news, for which we give thanks.

Since the opening event of Phase 1 (below), the fellowship have not stopped working on the older parts of our buildings (Phase 2).  The Fellowship Hall has been refurbished and also now has a kitchenette.  Through the generosity of Youth Grants, we have been able to refurbish the stage in the Fellowship Hall, complete with lighting and sound console, giving the young people the facilities and space to put on shows or concerts.  Another Youth grant was used to develop a new Internet Lounge in which the youth can meet and relax and make use of the computer facilities available there.

Saturday 7th July 2007

Thanksgiving Service
& Opening Event

We were thrilled to welcome a number of special guests and friends old and new who joined us for our Thanksgiving and Opening Service for on Saturday, 7th July 2007

We were delighted to welcome back our former Minister, Stephen Biddall, who spoke at the Thanksgiving Service

Watched by Members & Friends, the Treasurer of the Welcome Centre Project was invited to cut the ribbon at the Official Opening.

The Welcome Centre buzzed with conversation and activity during a splendid tea.

The project time-line and, bottom left, a Certificate of Merit that we were very proud to receive for our project, presented to us by the Essex Environment Trust (click on this picture to see a larger version)

Bob Eagle (a former member of PABC) entertained us with laughter and song through his 'Fun Gospel Music Show' www.bobeagle.co.uk

The four photographs (right) show The Welcome Centre (Phase 1) as it now stands, in regular use by the public from our local community.

We were been pleased to welcome the National Blood Service as our first public users
for some of their blood donation sessions in Clacton.

We now also host many other Clubs and organisations, and welcomed our first two Residential Youth Camps during the School Summer holiday in July & August 2007.

In addition our own Youth and Church organisations are able to make very good use of the Welcome Centre.

Easter Sunday
16th April 2006

&

Easter Sunday
8th April 2007

Re-dedication of the Site
We re-dedicated the site in a short ceremony on Easter Sunday 16th April 2006 (below), after which building began.

One year later, on Easter Sunday 8th April 2007, we held a dedication ceremony in the hall, just prior to it first coming into use.

22nd September 2006

 We took over possession of the building from Stroods, the Contractors - Phase 1a is complete!  We waited very patiently for a long time to get this far.  But 'The Welcome Centre' was not quite ready for use.

Phase 1b - the fully fitted kitchen, vinyl safety flooring, blinds and decorating all took place a little later, when we were confident that we had raised sufficient funds to allow us to continue with these.

8th August 2006

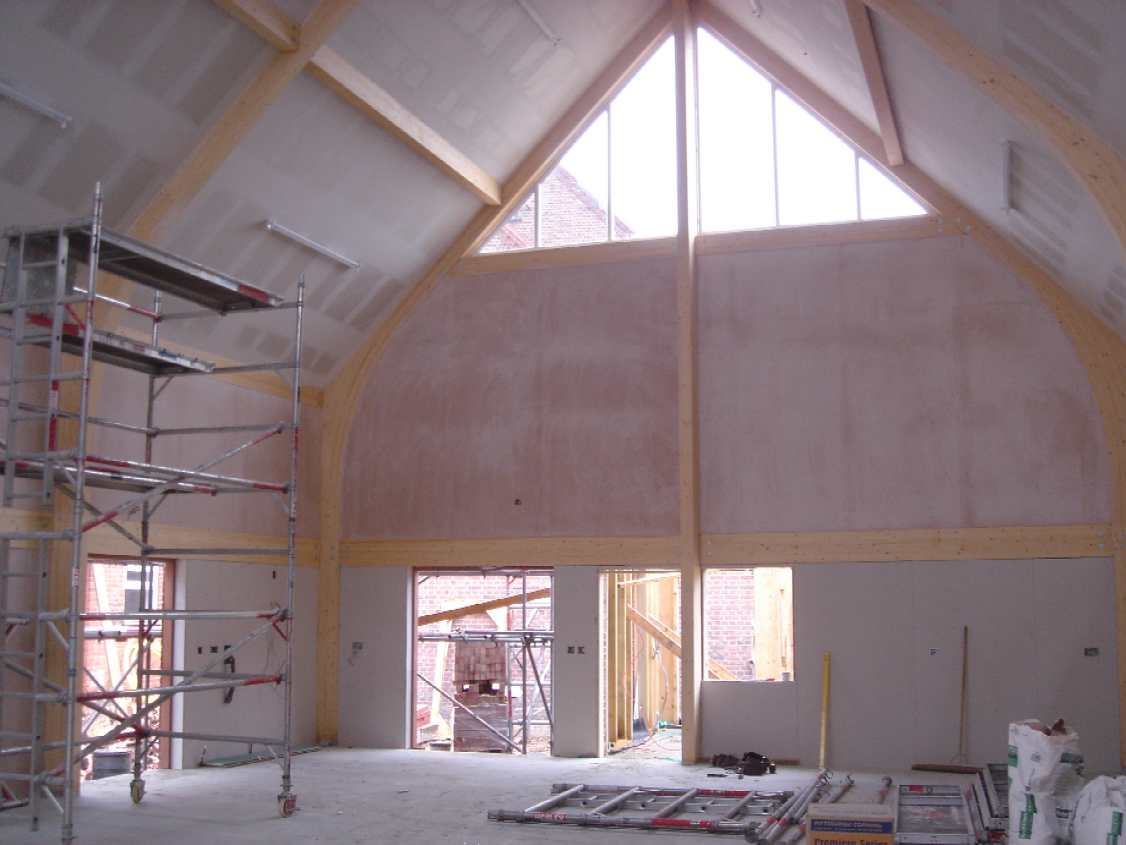

 Inside the Welcome Centre lights were now installed and outside the scaffolding had gone and the new kitchen roof made the first link between the new and the old buildings.

27th July 2006

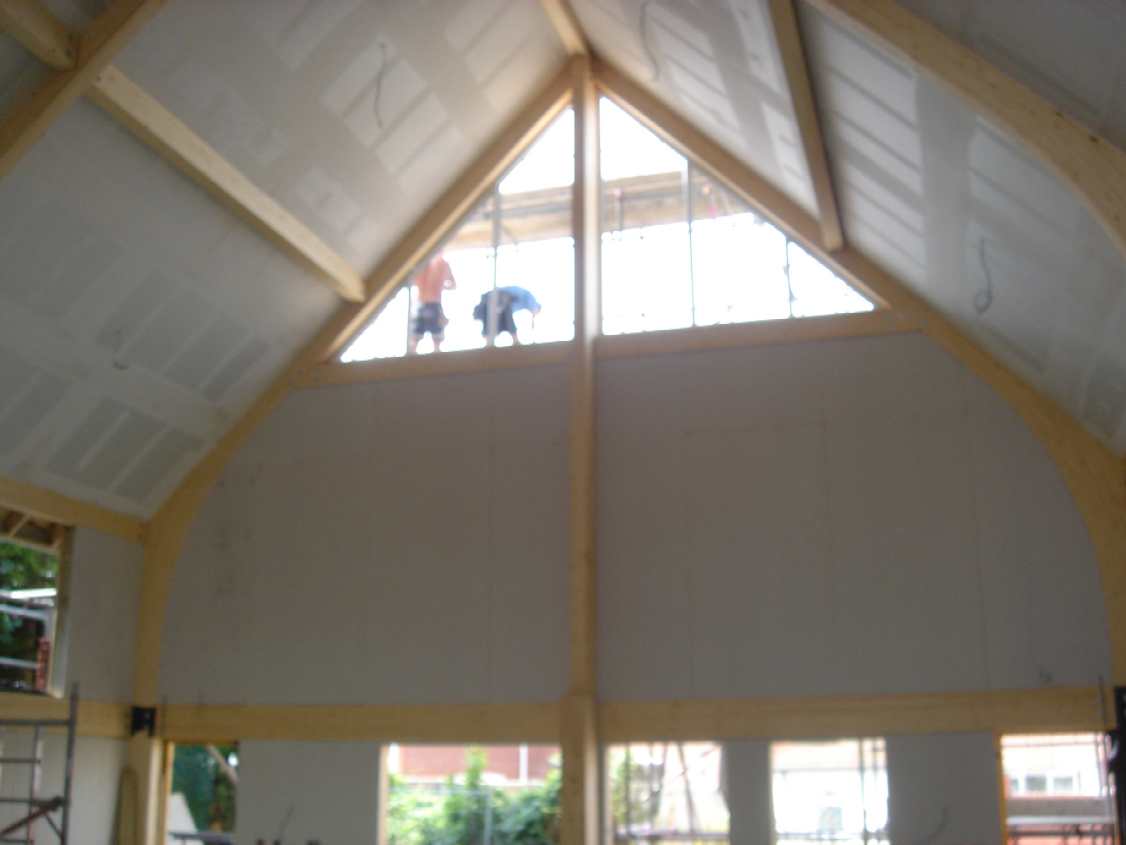

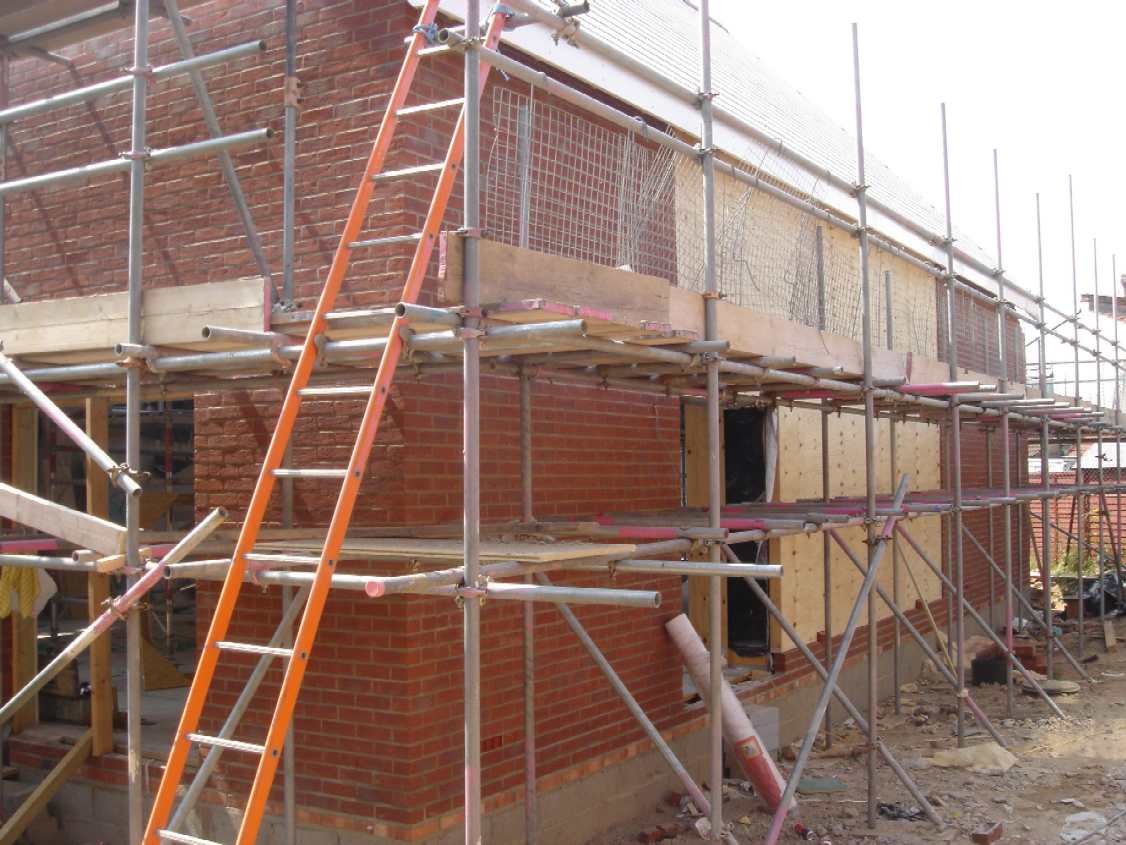

The window frames went in and the brickwork meets the roof & fascias.  Progress was rapid, but really discernable in photographs at this point.  We sought prayer as we went into the Autumn bidding round, asking charitable trusts to consider supporting us financially with the next Phase 1B - fitting of the kitchen, safe floor coverings throughout, window blinds and internal decorating.

Exterior late July

w/c 17th July 2006

The outer brick walls started to rise & the large triangular top windows have been installed.  Those were definitely men on the outside scaffolding, not a new breed of giant sea-gull on the window-sill! The ceiling inside was ready for painting.

Outside walls

Top Windows

Early July 2006

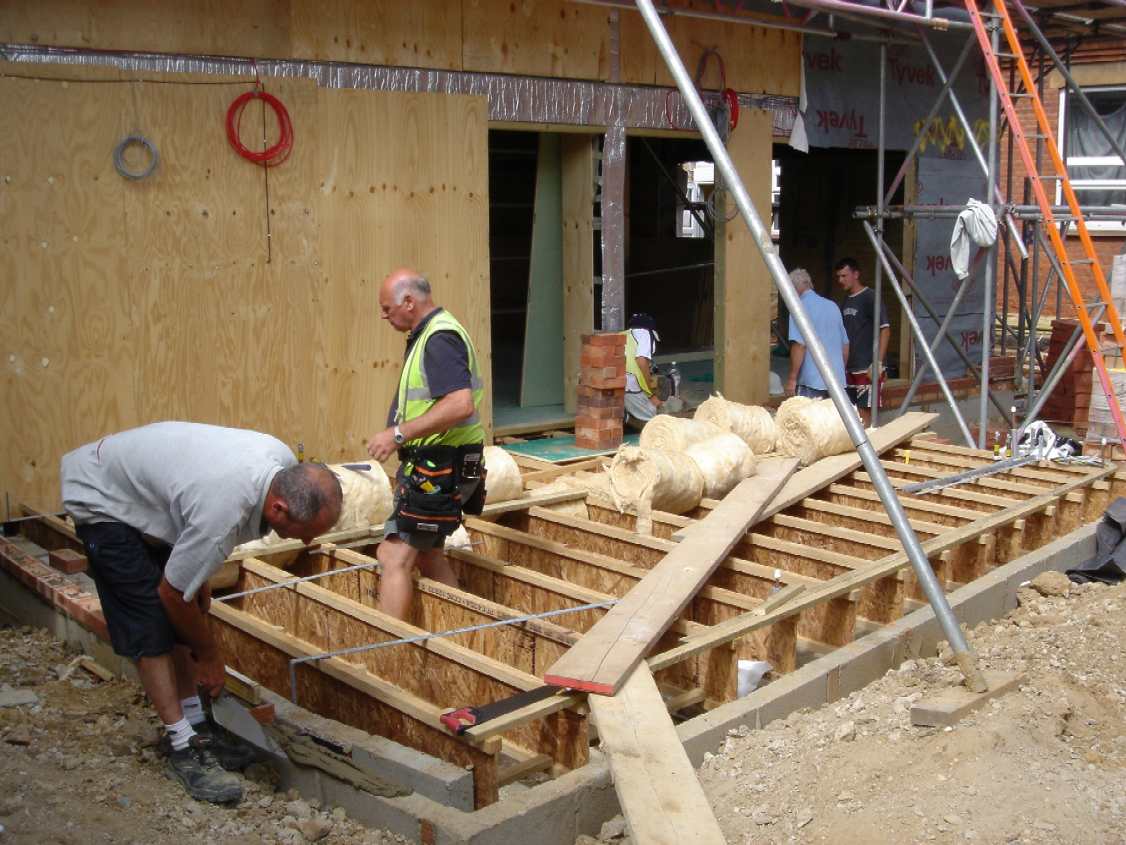

 The kitchen floor was insulated and the store (far right) both began to take shape from ground level.

Kitchen floor

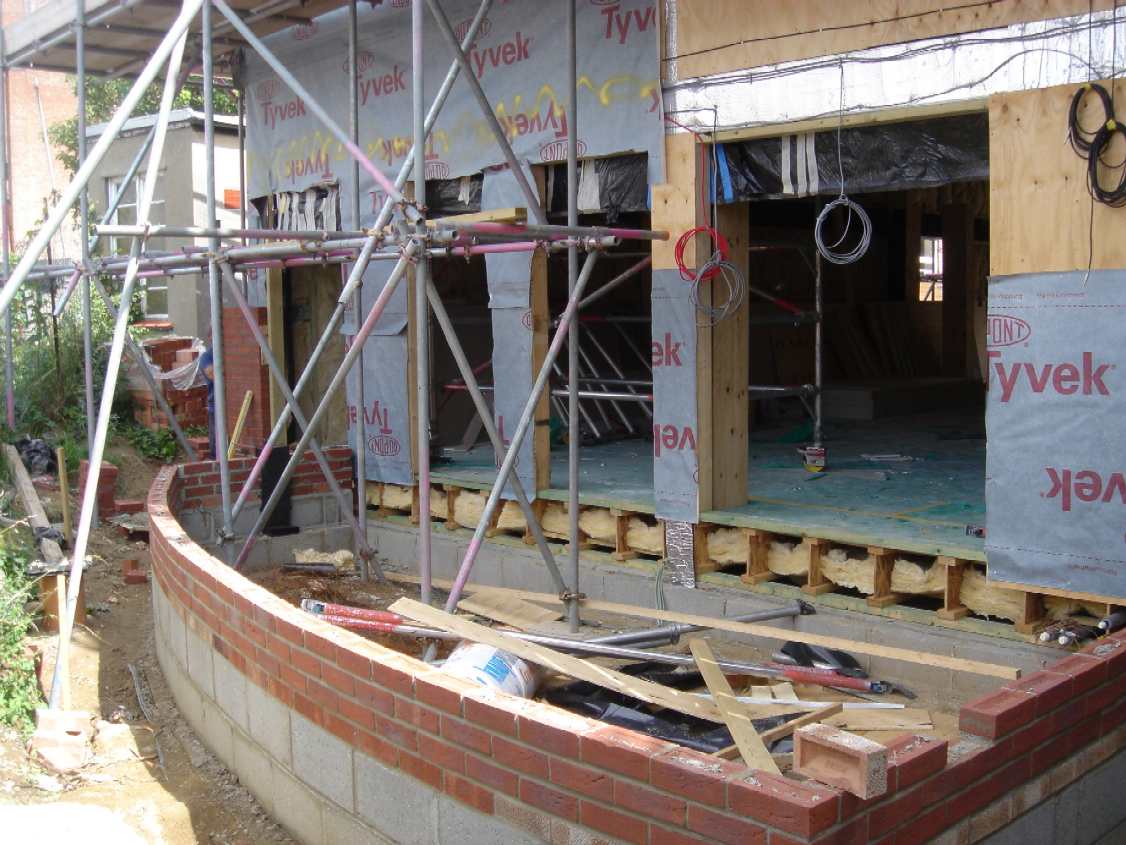

Store

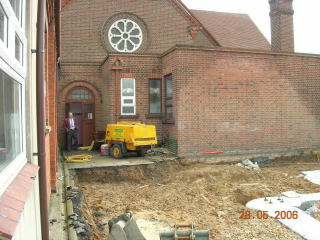

28th June 2006

 The roof was complete, the floor was laid and the whole project really began to take shape, as presented to us by site foreman, Chris (right).  Well done, lads!

Roof

Inside presented by Chris!

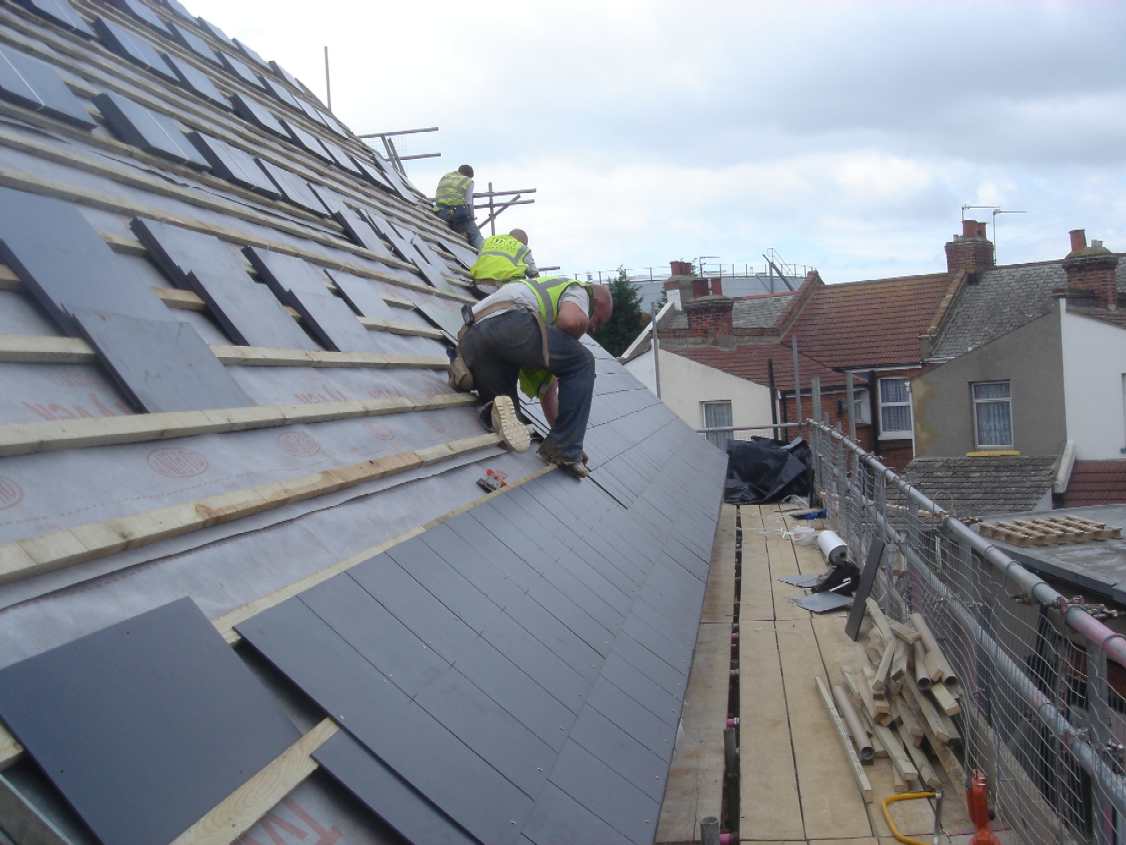

Tuesday 19th June 2006

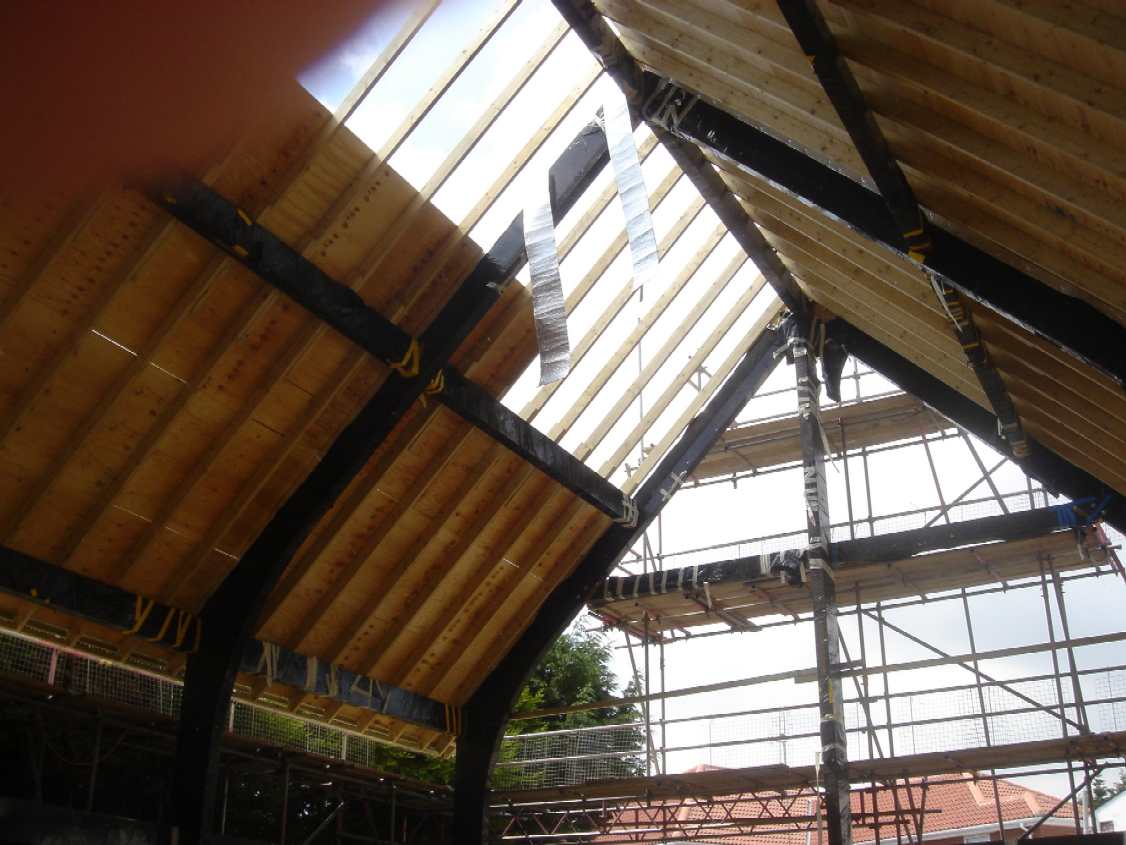

Over the last week, the rafters and roof were taking shape .  Some thought we were exaggerating when we said that access was difficult (far right) - 10 out of 10 was the score for this driver!!

Rafters & partial roof cover

Access is very difficult!

Tuesday 6th June 2006

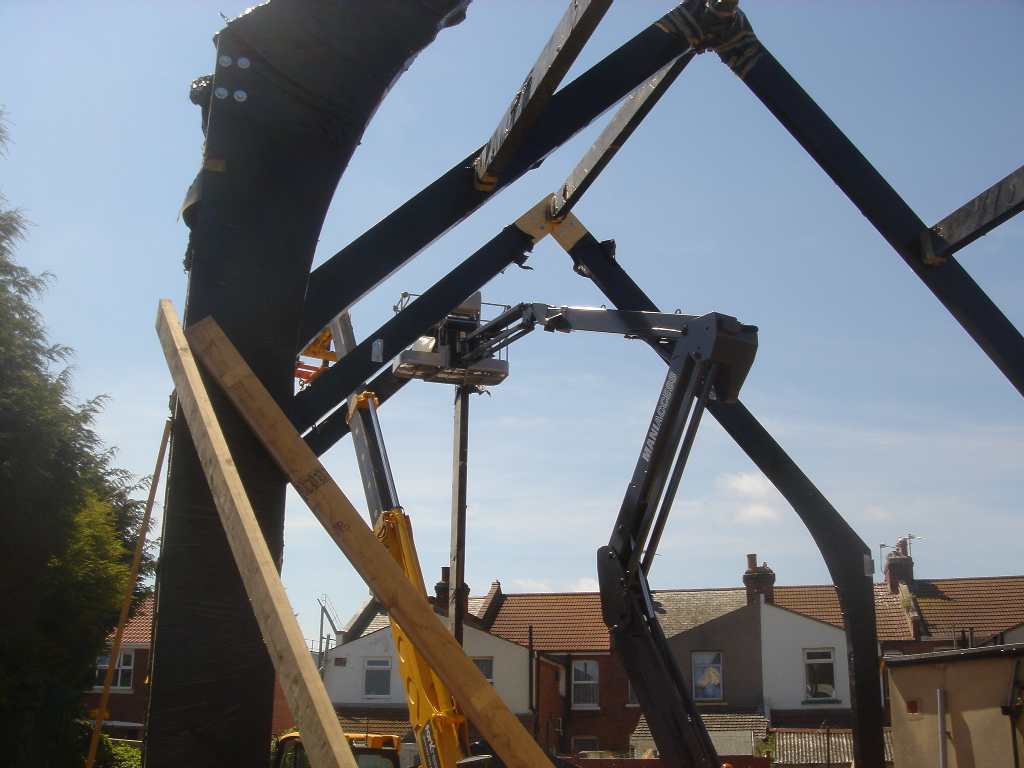

The sun continues to shine on
'The Sunshine Coast' as left, the penultimate portal frame was installed.  Far right, the aerial view from the 'cherry picker'.

Penultimate Portal Frame

Aerial View from the Cherry Picker

Friday 2nd June 2006

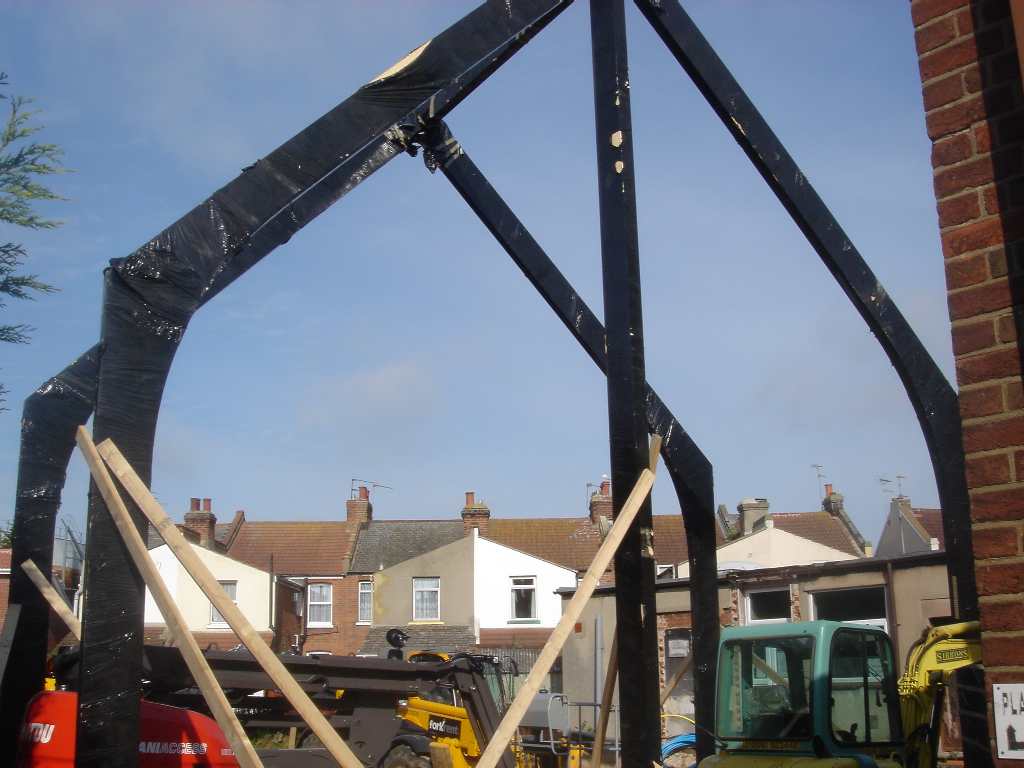

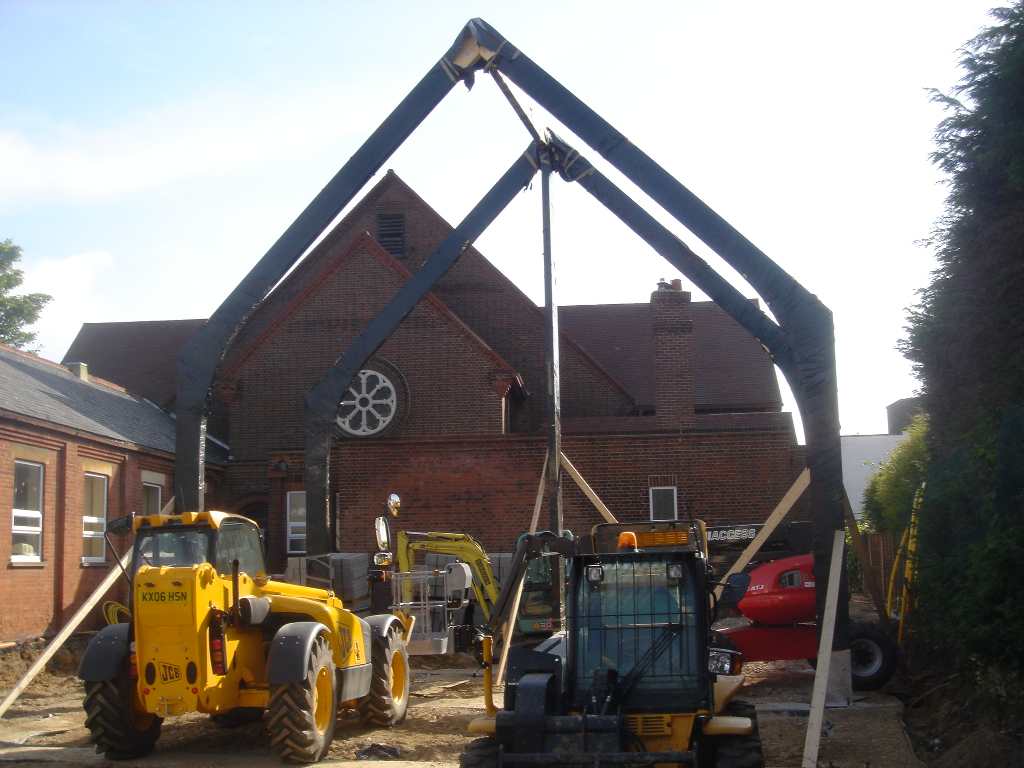

The week started out very wet (again), but with the first days of Summer came part of the portal frame (structure beams).  Despite what the picture (right) suggests, and contrary to popular belief, the new hall is not taller than the church itself!

Structure Beams 1

Structure Beams 2

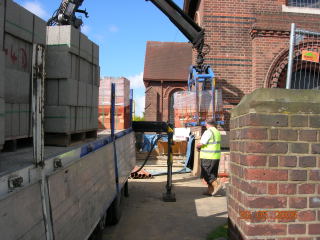

Tuesday 30th May 2006

  Who sneaked out to have a look then, Denis?  The delivery of the bricks, breeze blocks & timber was quite a feat in our small driveway.  We can't begin to think of the traffic chaos in Pier Avenue as the lorry took time to reverse its way in!

Thursday 25th &
Friday 26th May 2006

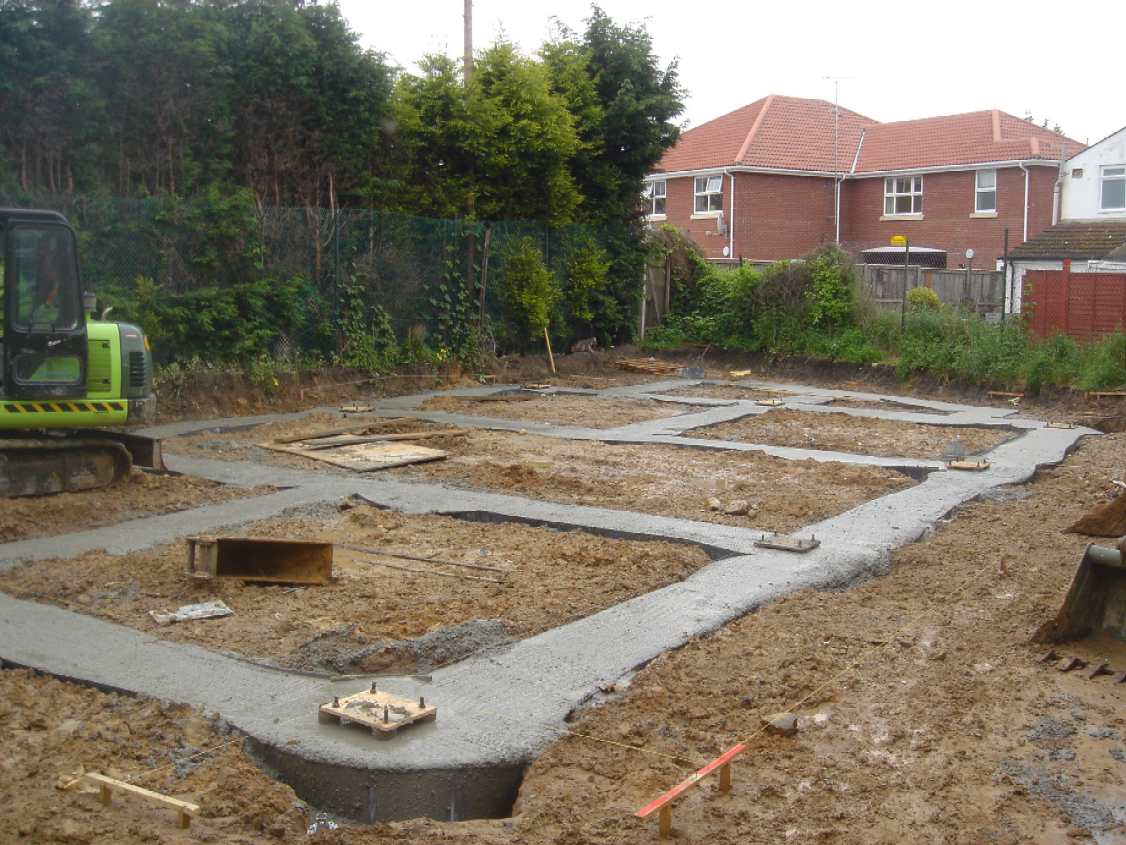

 Despite yet more foul weather (we wondered whether the sun would ever shine again!) concrete was poured in to make solid foundations.

Concrete Foundations 1

Concrete Foundations 2

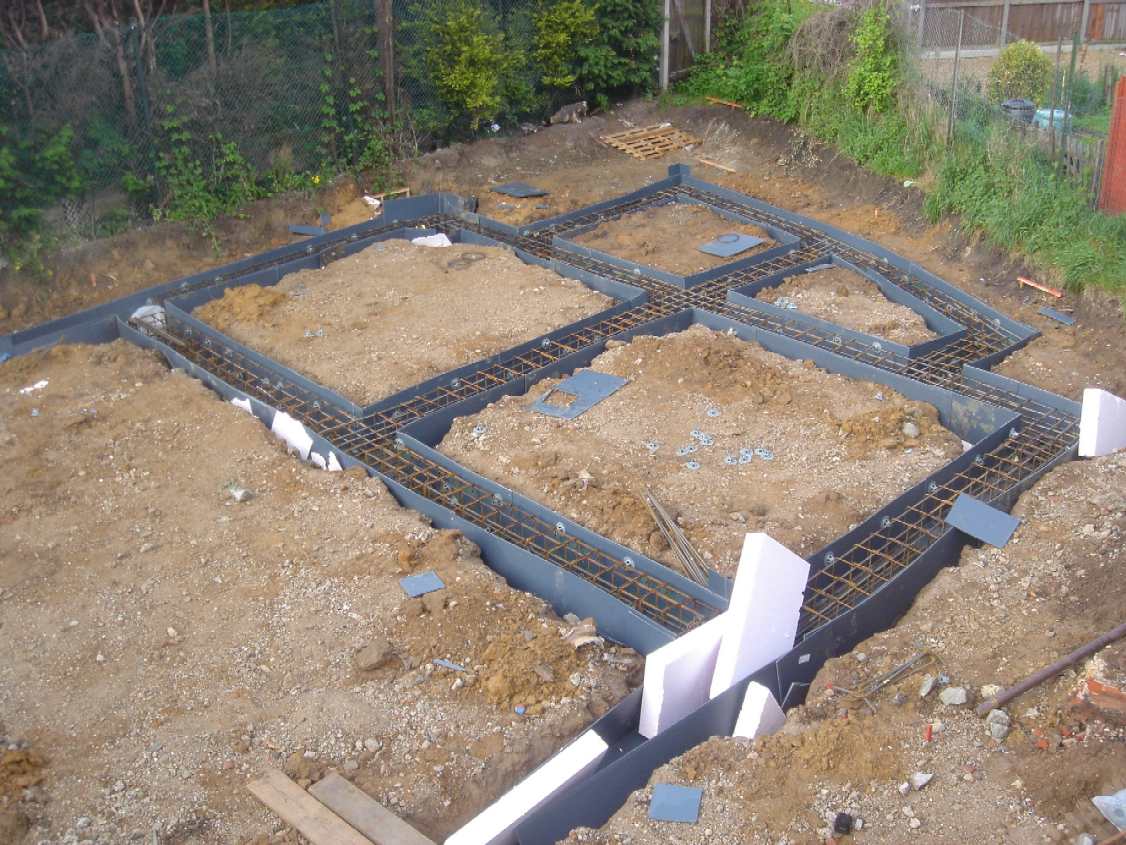

Digging out the foundations

Foundations ready for infill

Saturday 20th May 2006

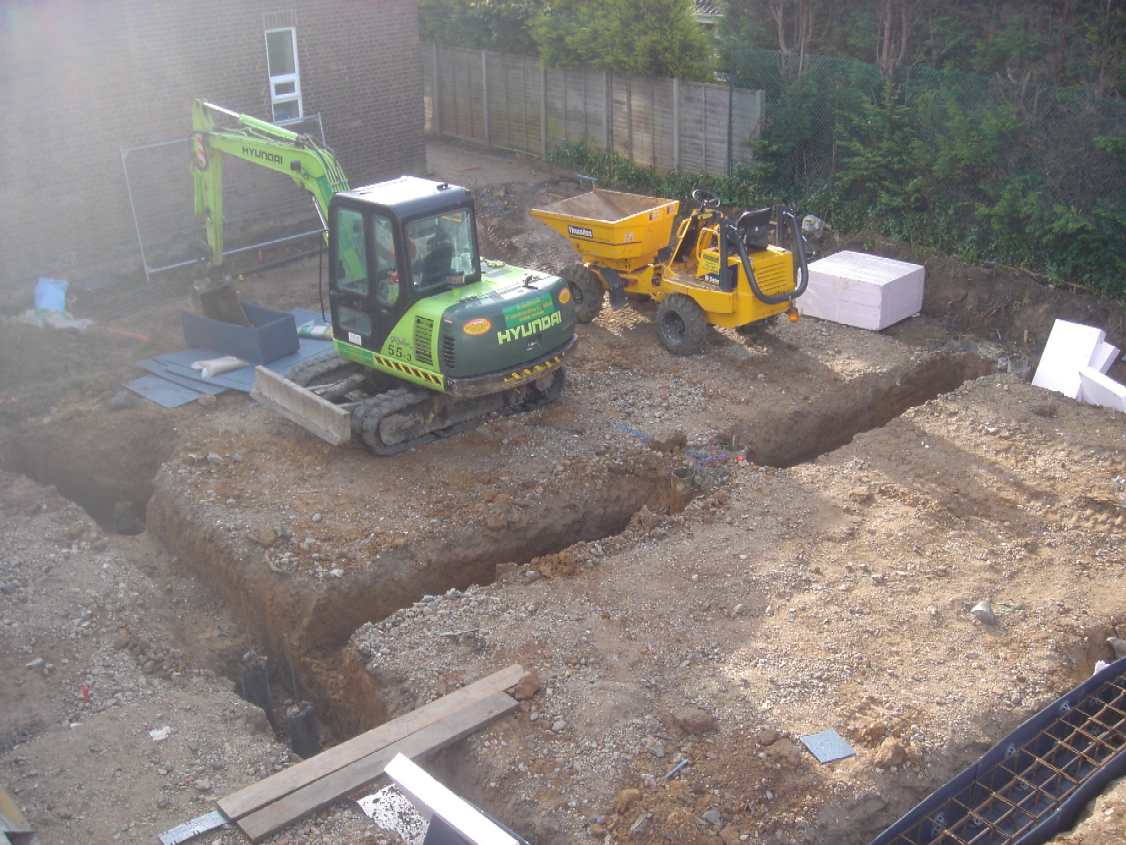

After all the rain, it stayed dry long enough in this week for the foundations to be dug out and the steelwork inserted ready for the concrete to be poured in.  We felt compelled to use this rare opportunity to relate the progress of the project to the biblical teaching of the need for good foundations!

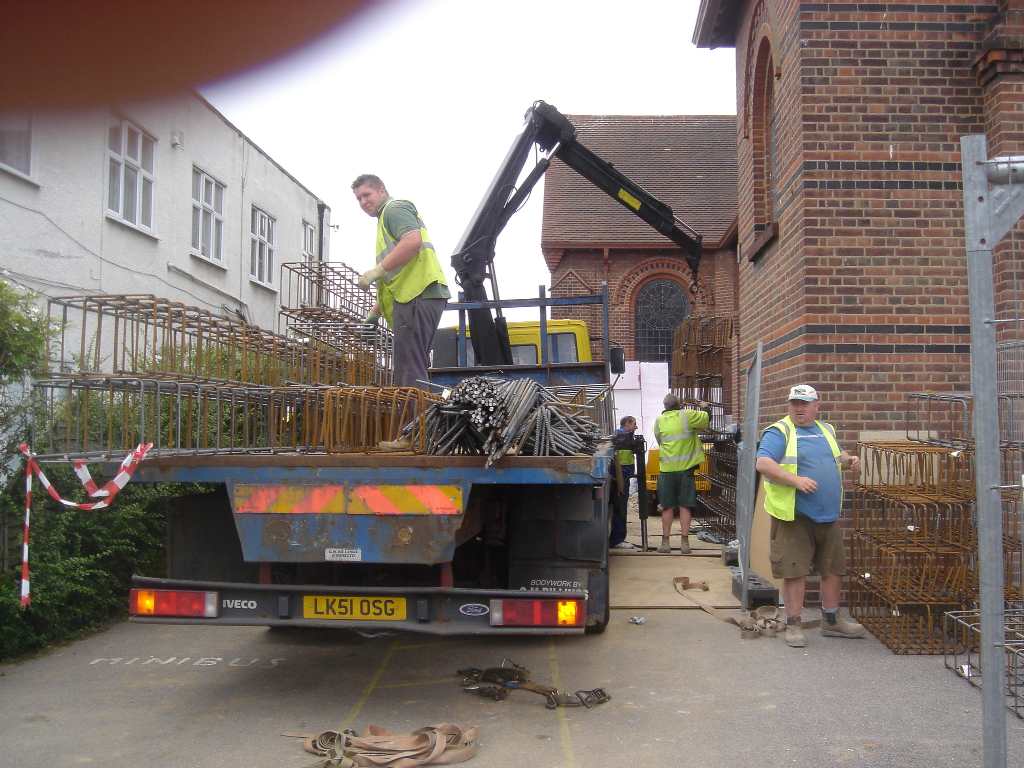

Delivery of the Foundation's steelwork

Digging out the Foundations

Monday 8th May 2006

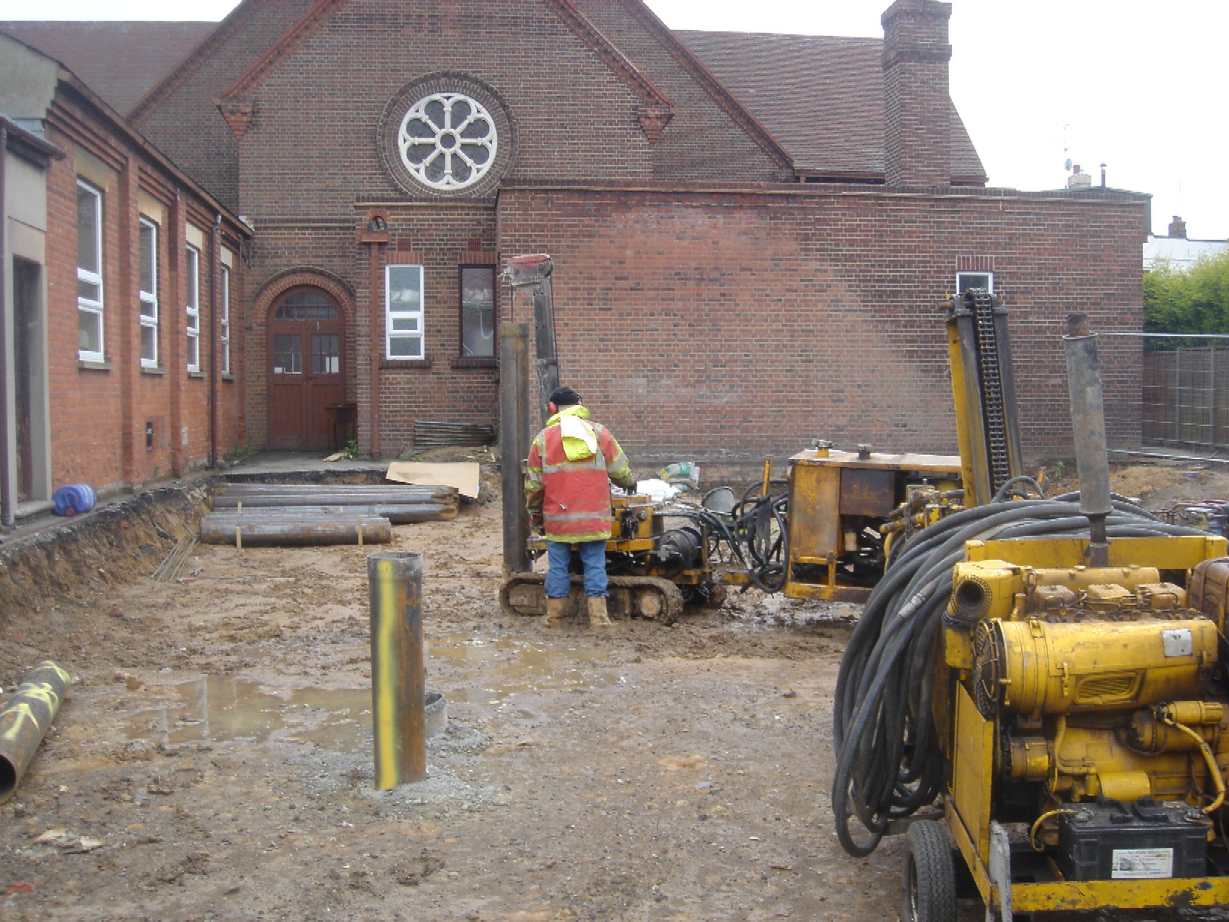

it rained relentlessly and the site more resembled a bog or pond than a building site!  Wellington boots and their owners were sinking fast, and the plant was at risk of doing the same.  Progress was very difficult for everyone but despite all the difficulties, the pile driving got finished almost on time.

When the piling machine was working, the trophies in the cabinet in the existing school hall (above left) vibrated and the lights in the Friendship Lounge at the front (street side) of the church were rattling.  So there was a bit of noise and movement, but it was not as bad as we feared it might be.

Piling after rain 1!

Piling after rain 2!

The site before it rained

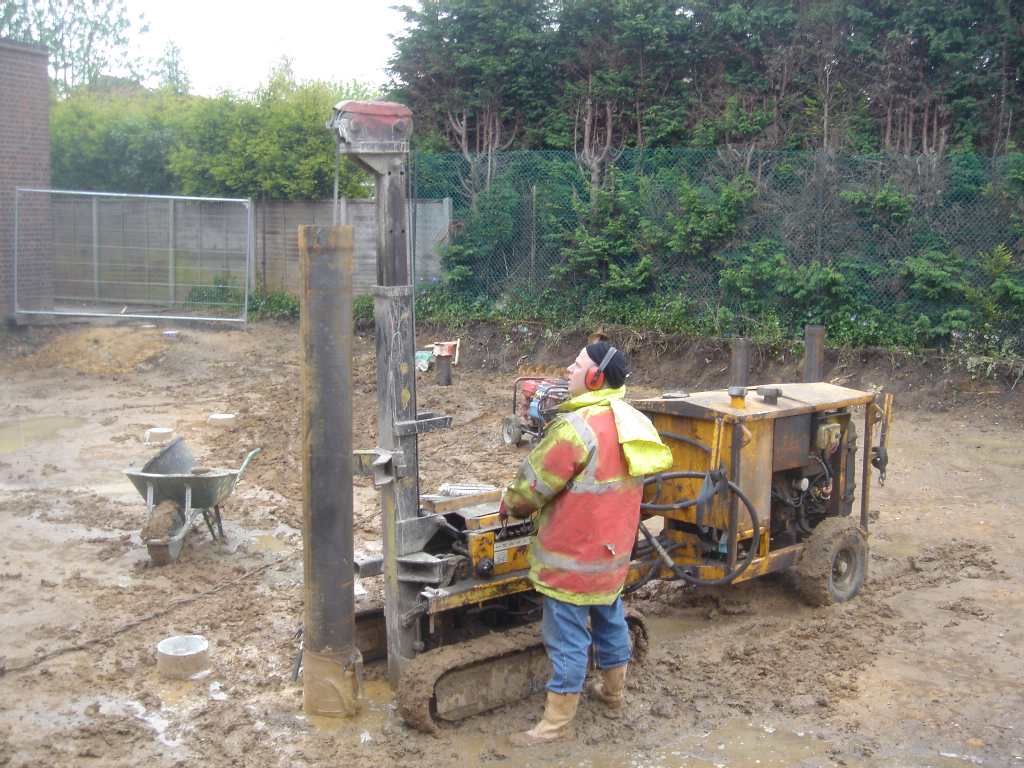

6th May 2006

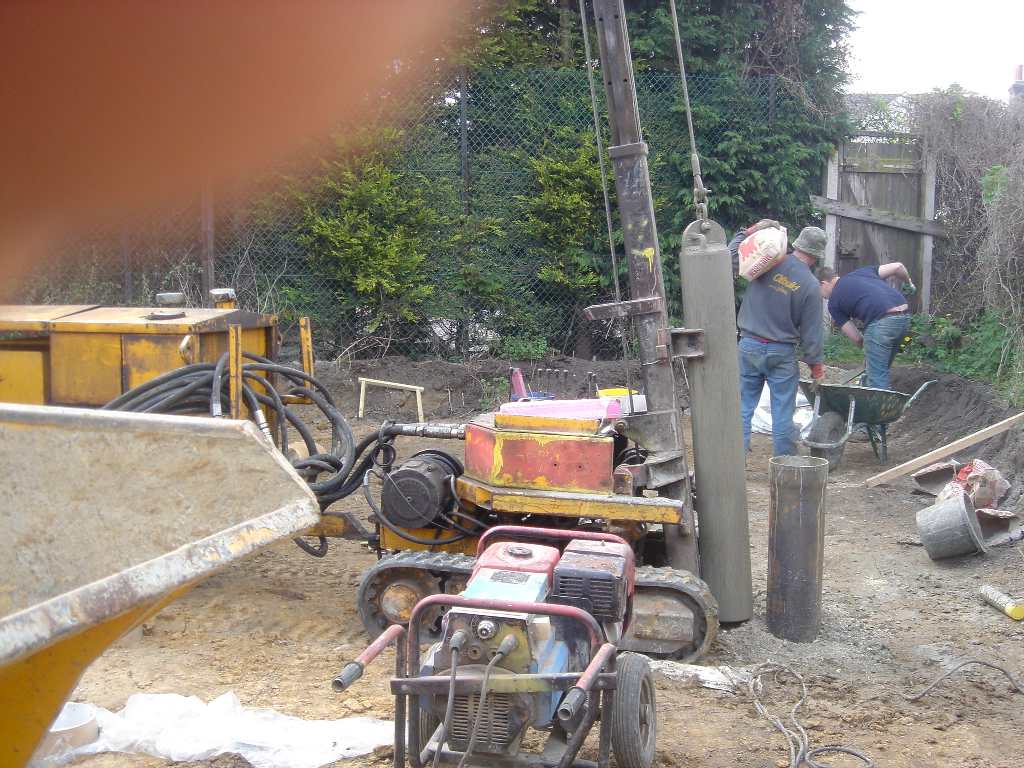

Piling Contractor at work
4th May 2006

The site was measured out and the auger brought in to start its work (far right).  Underground the site is quite a challenge.  Looking at the picture below right, the left hand side of the site has a layer of bedrock and the holes drilled by the auger were extremely dry & very, very hard, yet on the right hand side the piling holes were full of water from the water table!

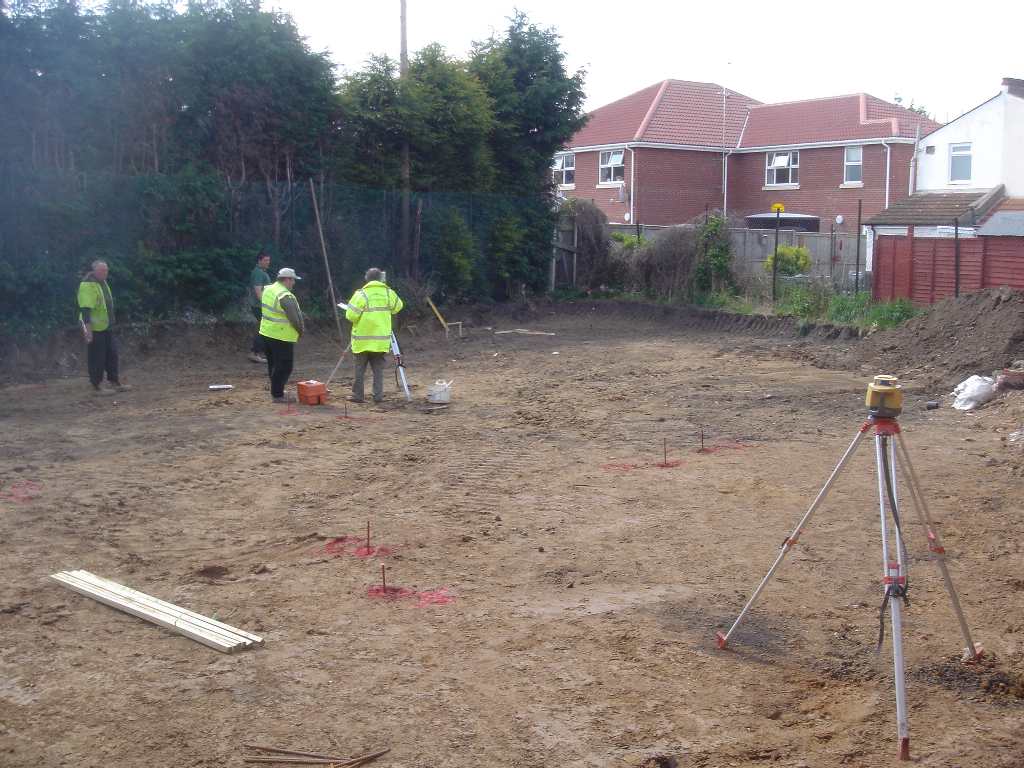

The Site is measured and marked out

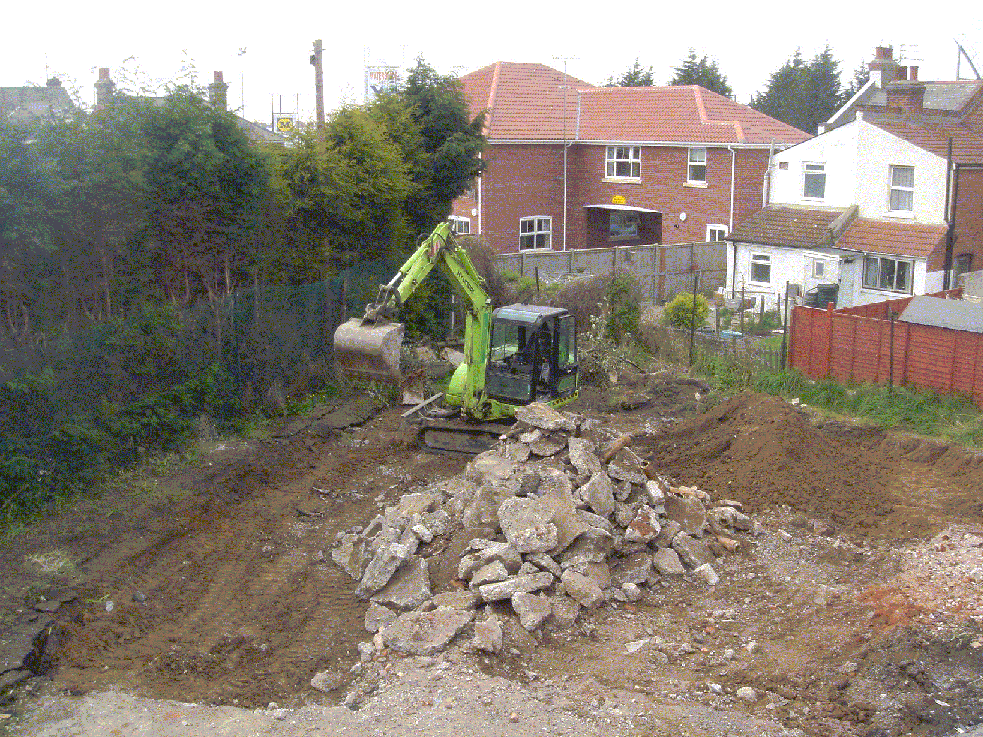

28th April 2006

Piling machine
4th May, 2006

The narrowest point of the access to the site was just 2 metres wide (6' 6") - see the gap between the building and the fence in the picture below left.  The clearance and construction was therefore quite a challenge for building contractor, architect and quantity surveyor.  Everything, plant, materials, etc. - all had to go through the gap.  The site was cleared by a mini-digger (below right) which when it went through the gap had 1/8th of an inch to spare! (see the pictures further up)

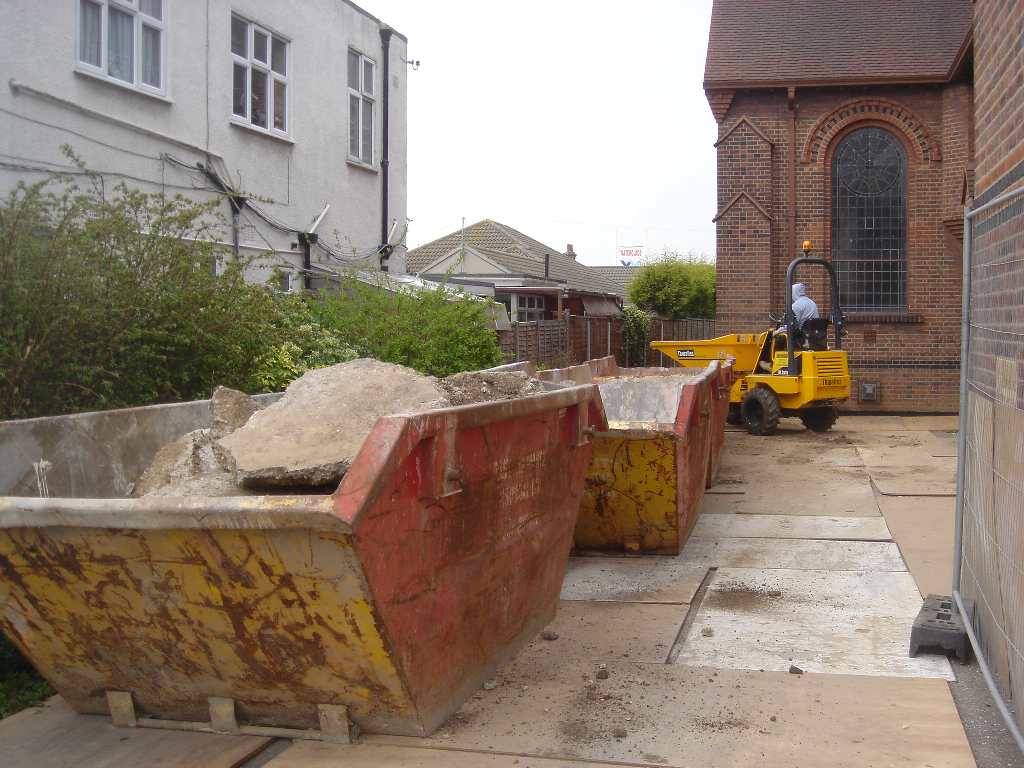

Waste Skips - April 2006
April 2006

Mini-Digger April 2006

New challenge

In 2000, our Church fellowship sensed the Lord challenging us to “build for the future”. Our Church centenary was only a couple of years away (in 2002) and our youth hall was ninety years old and in a poor state of repair – we felt that God was leading us to undertake a building scheme to provide good quality space for future ministry and to benefit the community.  We have been lovingly and generously supported by charitable trusts, other Baptist churches in the Eastern Region and further afield, by friends and supporters in Clacton and the wider area of Tendring, and most generously and sacrificially by our own friends and members.  We worked with an Architect and Quantity Surveyor, and had loans approved.

This first Phase 1 & 1(a) brought the completion of our new multi-purpose Community hall and Phase 1(b) the fully fitted kitchen, blinds and vinyl flooring for the hall, cost us a little over £400,000 in total.  Phases 2 (The Atrium - now under construction (costing around £220K) involves building an “atrium” over the central outdoor area between the original buildings and the new Welcome Hall.  The refurbishment of surrounding rooms has also taken place (refurbishment of an original hall to include a new stage, and lighting/sound console, a new kitchenette and a Internet Lounge.  Phase 3 will involve the total refurbishment of old toilets and a lounge to create a shower & toilet block which will include a wet room for the use of the disabled.

Definitely a "mission" project

This is very definitely a “mission” project. The idea is not merely to build a Church hall – we want to create a modern space that will be of real benefit to the local community. We envisage a wide range of activities going on there – perhaps a luncheon club, or a drop-in centre, baby clinics, toddler groups, youth activities - building on some of the work that is already going on at Pier Avenue, and opening up new avenues of service and mission. We would like to create a network of partners, with whom we can work to make Clacton town centre a better place – making God’s love known.

The Welcome Centre was completed and available for use in the Spring/Summer 2007.  We enjoyed a formal Service of Thanksgiving and Opening Ceremony on Saturday 7th July 2007.  The site of the new Atrium was dedicated after the morning service on 25th October 2009 and construction takes place between November 2009 and January 2010.  Please pray for us, that God will continue to enable us to fulfil the vision he has given. Our Church is over 100 years old – now we are “building for the future”, having put up a structure that will still be making a difference in generations to come.
